I plugged the numbers into a spreadsheet using the conditions you specified. The short answer:ORIGINAL: ElvisDaKing
I have a question
July 1942, I plan to start from scratch R&D program for Ki-100 I Tony.
I will have 3 R&D lanes available
I was wondering if it s faster to start the R&D with Ki-100 I Tony, or to go through the whole 'Tony' lane starting with Ki-61a ?
SC 1
PDU ON
I will not produce any Kawasaki Ha-60
My point is that Ki-100 I Tony is available on March 1945, so it will take very long time to build the R&D Ki-100 I Tony from 0(30) to 30(0)
But if I start with Ki-61 Ia Tony available February 1943, it is very likely that my 3 lanes will be fully functionnal [30(0)] by end of 1942, and then jumping from Ki-61 Ia to Ki-61 Ib (09/43) , Ki-61 Id (04/44), Ki-61 II KAI (08/44)...
So what should be fastest option to get the Ki-100 Tony ?

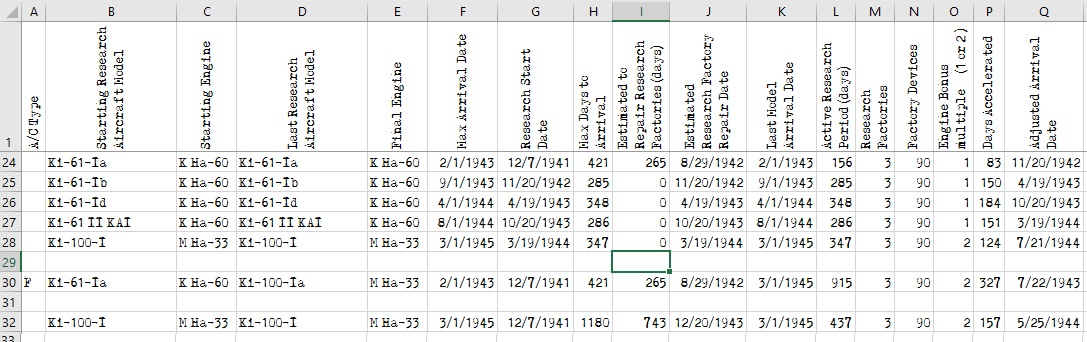

- If you research the Ki-100 as an base model, factories repair on approximately 12/20/1943 and would then arrive on 5/25/1944.
- If you research each step along the line fully before starting research on the next in line, the Ki-100 will likely arrive on 7/21/1944 - almost 2 months later.
- If you research the air frame and then decide to try a new engine, the Ki-100 becomes available on 7/22/1944, approximately 10 to 12 months earlier.
Please note that these are theoretical calculations based upon predicted dates for repair of the research factories. YMMV.
Also note that in all cases, I assumed that you had > 500 Mitsubishi Ha-33 engines in the pool during research of the Ki-100, but 0 Kawasaki Ha-60.
