07-08 September 1942
Solomons
The American carriers are NE of Lunga in the "Santa Cruz" position. Except for pounding Tass we don't offer them much of a target over that way. The B-17s paid us their usual visit at Tass. We now have 495 supply on the ground but supply in the units has dropped to about 20%. Airbase at Shortlands is 22% completed. I'd estimate another 78 days prior to completion or about late November.
New Britain
The airfield at Gasmata is now 7% - we will need another engineer in order to complete this field before the end of the scenario.
Papua
One more run and we should have all of the 2nd Maizuru SNLF back at Rabaul - then all four SNFLs planning for the Milne Bay operation will be concentrated at Rabaul.
Truk
The AO have 13000 fuel so hopefully one more turn and they will be full and heading South. The second pair of "Kongos" arrived - so we now have 6xBBs. The 2nd Div engineer will load up and head to Buka - it will ride in our second AMC which will then head to Rabaul to join the first AMC and several other large AK which will act as the transport force for Milne Bay.
Planning
Well instead of sending a second construction engineer (the 3rd Construction Engineer Bn) to Finschhaven - maybe we will send it to Gasmata instead. Finschhaven already has a port - and building an airbase there will not do us as much good as one at Gasmata - because one at Gasmata will give us a jumping off point to project some APD runs into Buna directly - not sure we can supply Buna any other way - and worst case this also gives us some protection if we evacuate.
Since the American carriers are out - we probably will hold off on the surface attack on Lunga and shift our energy all towards the Milne Bay operation. But the biggest problem with doing Milne Bay now is that several of the SNFL are still not up to 50 planning points yet - and doing a landing with less than 50 planning points is a poort idea.
The other idea might be to try to build up some naval support at Rekata Bay and then eventually try some small AKL runs into Tass - problem with that is by the time it is set up there will certainly be aircraft at Lunga.
So that leaves us the option of staying put in port with the fleet and building up a bigger reserve of fuel - we can't have too much fuel in this scenario - and Rabaul will actually need some more soon. So ok that will be the plan - do a tanker run to Rabaul and then wait another week for the Milne Bay troops to get some more planning points and build up so more fuel. We have 2 more AO sitting empty so we will try to fill them up before the op. This will give us 6 total AO loaded with fuel for the OP. Also if we out wait the American carriers maybe we can do the Op with them back in port.

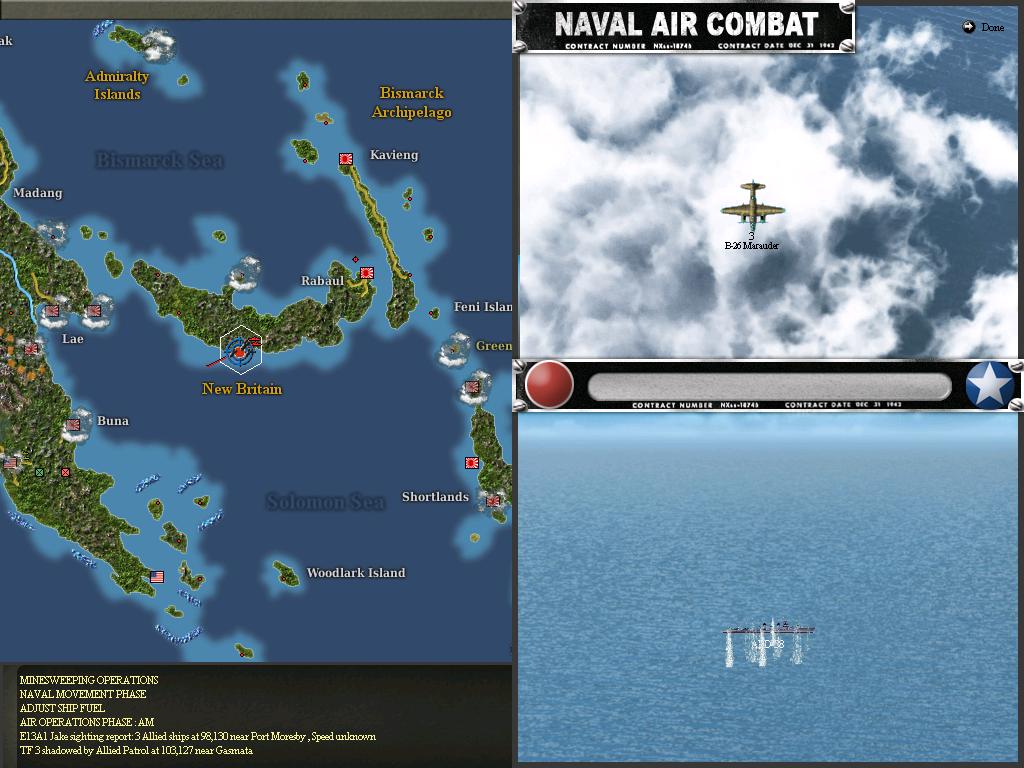

Oh a few B-26 attacked our fast transports unloading supply at Gasmata this turn - but the planes missed and we delivered the supply Here is a pic.
